Skip to content

Estimate, committed, actual

Written by the Jobivo team · Updated 4 min read

Every cost on a job passes through three figures: what you planned, what is on order, and what has been spent. All three are on the job's Financials tab, next to the price you are charging, so you can see what the job is making while there is still time to act.

Where to start#

Click Jobs in the side menu, open the job, then click the Financials tab. The page is one long scroll. The row of buttons under the tabs jumps to each part: Figures, Invoices & quotes, Costs, Purchase orders and Expenses. Which of them you see depends on your role and on the modules your company has switched on. On a job with nothing priced yet, a Price this job card leads the page: click Start a costing to go straight to the cost plan.

Jobs /JB-0241Boiler replacementIn progress
Job SheetSnagsFinancialsCertificatesFiles
FiguresInvoices & quotesCostsPurchase ordersExpenses

Figures: what the job is making#

The top of the page reads as a sum: Revenue less Costs is Profit. Costs here is what has been spent plus what is on order. Profit is green when the job is ahead and red when it is not. Under the sum, Costs over time and Getting paid show the same job against the calendar and against its invoices.

Revenue
£2,525.00
Costs
£1,596.00
Profit
£929.00
Margin
37%
£929.00 on £2,525.00
Billing position
£1,596.00behind
79% of the costs · 0% invoiced
Margin
Profit as a percentage of revenue. It appears once the job has a quote or an invoice.
Billing position
Compares how much of the costs you have used with how much you have invoiced, and says whether you are behind or ahead.
Overdue
A red card that appears only when an invoice on the job is past its due date. Its link goes to the job's invoices.

Costs: the four figures#

Click Costsin the row of buttons. Four figures sit above the cost plan. They are worked out from the lines below and from the job's purchase orders and expenses. Nothing is typed into them.

DraftInternal cost build-up — the customer only ever sees the quote.
Cost
£2,020.00
Price
£2,525.00
Committed
£1,400.00
Spent
£196.00
Cost
What the planned work costs you: every line's quantity at its unit cost.
Price
The same lines with their markup added. This is what the plan would sell for before VAT.
Committed
The value of purchase orders you have sent that has not been received yet. It shows only when purchase orders are switched on.
Spent
The expenses logged against the job, including goods received on a purchase order.

Add what the job will cost#

Under Cost plan, click + Add line. In What is it?, search your price book and pick the item, or type a new name. An item from the price book fills in its cost, category, unit and markup. Check the quantity, click Save line, then click Save on the cost plan to keep your changes. To change a line later, click its row.

Add line
What is it?
Combi boiler 30kW
Cost (£)
1250.00
Category
Materials▾
Quantity
1
Unit
 ▾
Markup %
25
Price (£)
1562.50
Customer quote only shows price (no markup or cost)
Charge VAT✓
Net
£1,562.50
VAT
£312.50
Total
£1,875.00
DeleteCancelSave line
What is it?
The name of the cost, such as a boiler or a day of labour. It searches your price book as you type.
Cost (£)
What one unit costs you.
Category
Materials, Labour, Plant & equipment, Subcontract or Other. It shows as a column on the plan.
Quantity
How many units the job needs.
Unit
What the quantity is counted in, chosen from your company's units.
Markup %
What you add on top of the cost. Change it and the price follows.
Price (£)
What you charge for one unit. Type a price and the markup is worked out for you.
Charge VAT
Tick it if VAT applies to this line. The Net, VAT and Total figures under it show what the line comes to.

Planned against actual, line by line#

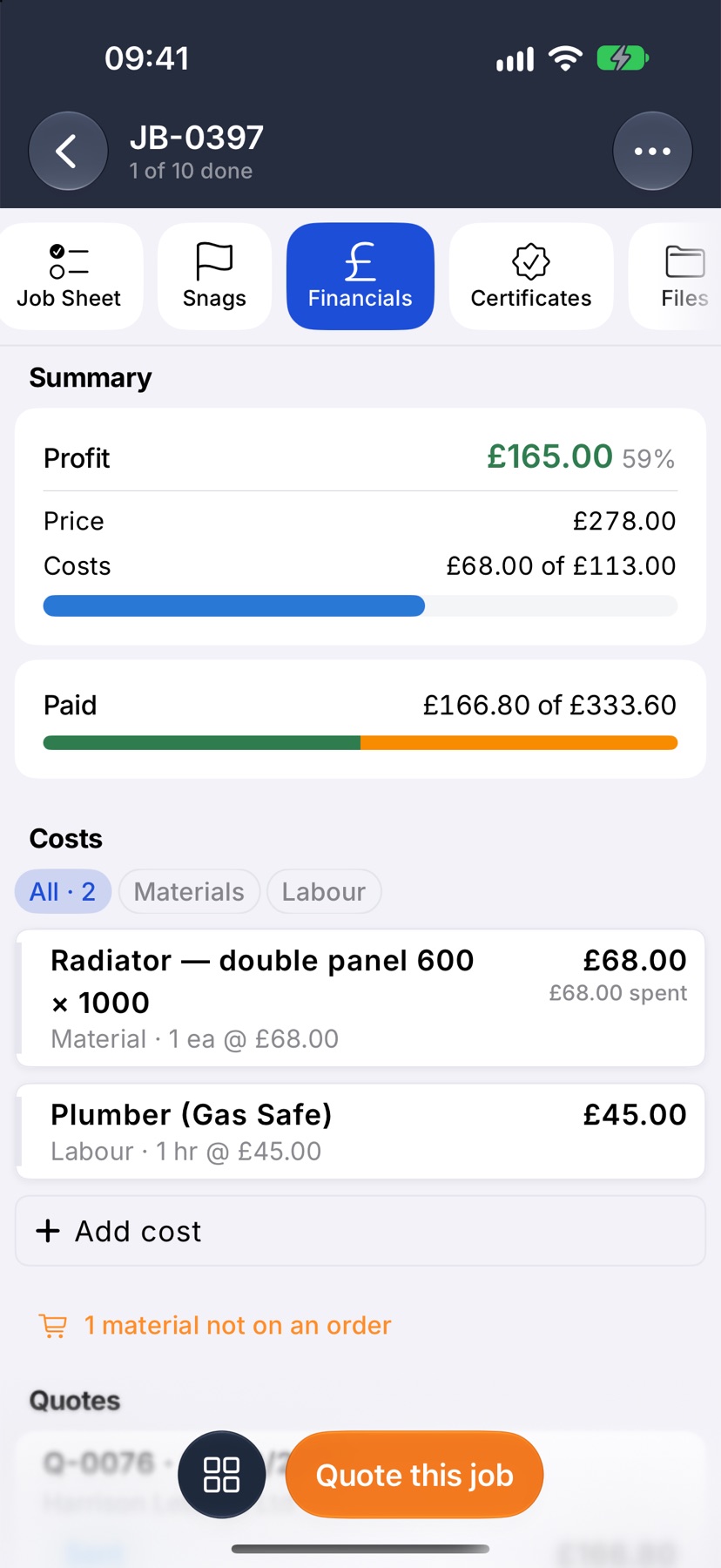

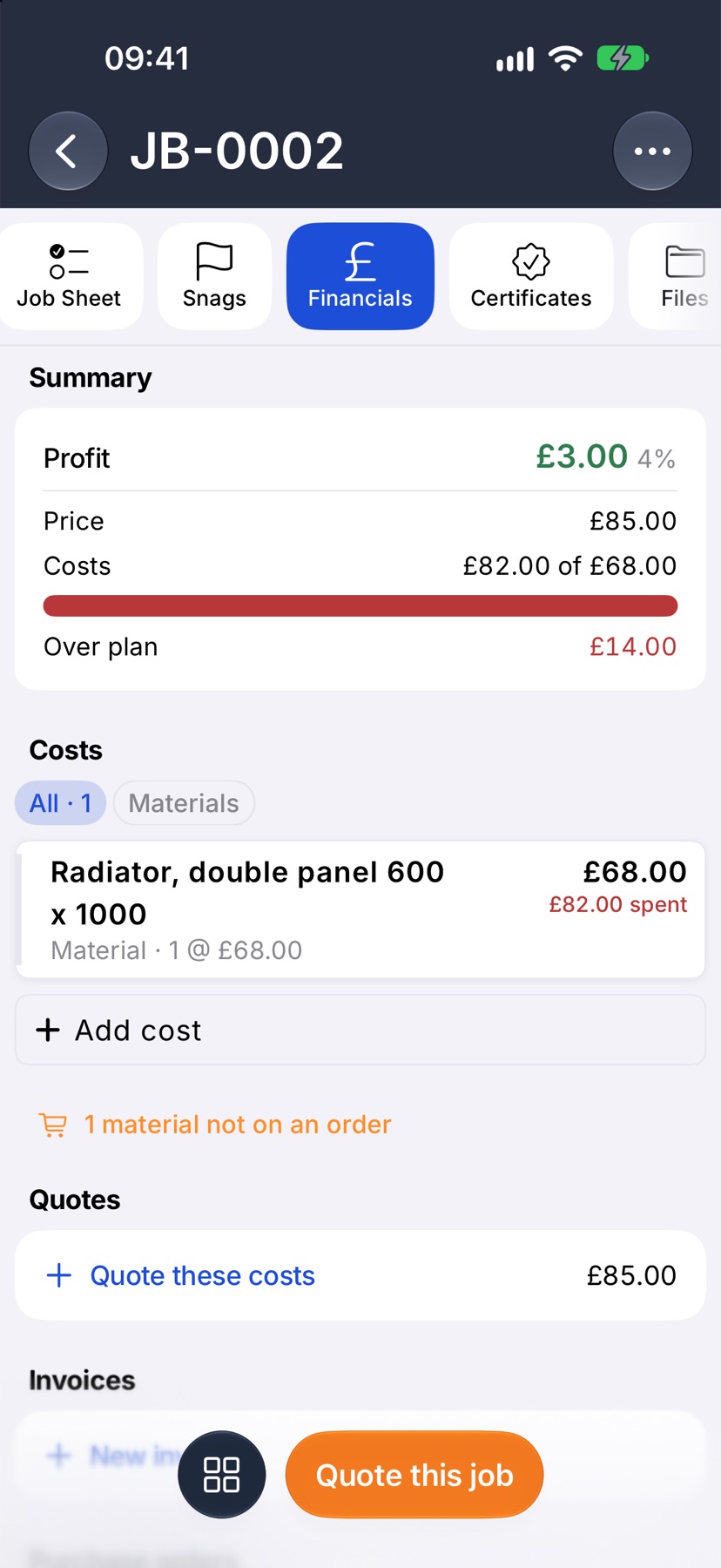

Each line of the plan shows its planned Total, then what has happened to it. While its materials are on a sent purchase order, Actual shows the amount on order. Once an expense is logged against the line, Actual shows what was spent and Difference shows how far that is from the plan: red with a plus when it cost more, green when it cost less. The foot of the table shows how much of the plan is left, or how far over it the job has gone.

Cost plan
SaveGenerate quote
LineCategoryTotalActualDifference
Combi boiler 30kWMaterials£1,250.00£1,250.00 on order—
Magnetic system filterMaterials£150.00£150.00 on order—
Flue kit and fittingsMaterials£180.00£196.00+£16.00
Installation labourLabour£440.00——
+ Add line£424.00 left of plan
1 cost logged on this job£196.00 ›

How a cost moves from planned to spent#

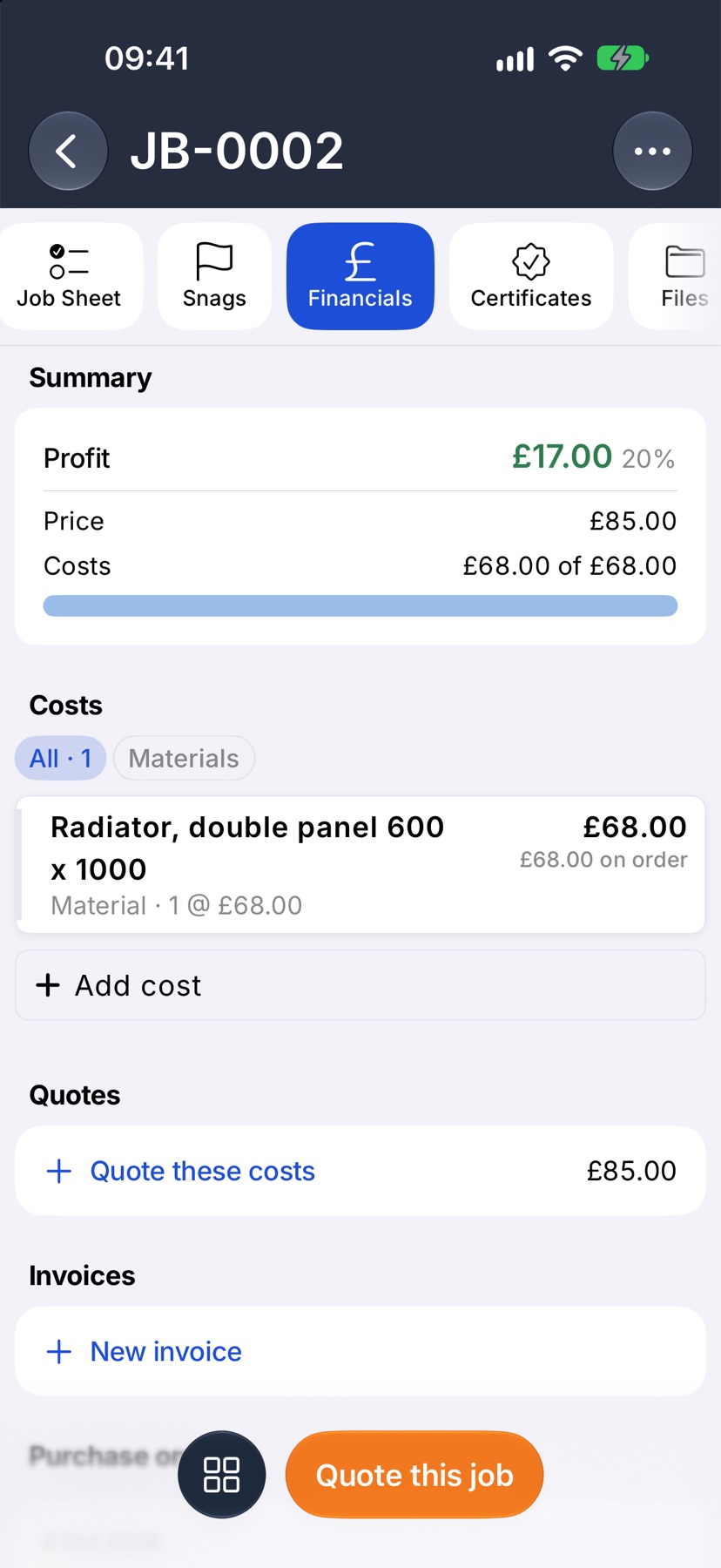

Nothing is marked by hand. When you send a purchase order, its value counts as Committed. When you receive the goods, that value leaves Committed and becomes an expense, so it counts as Spent. An amount is never in both figures. An expense you log yourself goes straight to Spent, and on a job you can say which line of the plan it paid for.

DraftInternal cost build-up — the customer only ever sees the quote.
Cost
£2,020.00
Price
£2,525.00
Committed
£1,400.00
Spent
£196.00

Quote from the plan#

When the lines are in, click Generate quote. A preview shows the quote the plan will make, and Generate quote in the preview creates it and opens it. The customer sees your prices and never your costs or markup. The button stays greyed out until the job has a customer and at least one finished line. If you change the plan while its quote is still a draft, a notice tells you to generate it again.

Lock the plan#

Click the three dots beside Generate quote and choose Mark final. The plan's status changes from Draft to Final and the plan is locked. Choose Reopen in the same menu to edit it again.

On a job with sub-jobs#

Figures shows the whole job, with a Per sub-job breakdown under it. In Costs, each sub-job is a row you click to open, with its planned cost on the right, or the amount it has gone over in red. Add a cost with the + Line in row inside the sub-job it belongs to. The card above the rows adds everything up.

Planned cost£3,480.00
Committed + spent£1,596.00
Left£1,884.00
▾1Boiler replacement£2,020.00
+ Line in Boiler replacement
▸2Replace hallway radiator£1,460.00
Planned cost
Every line on every sub-job, added together.
Committed + spent
What is on order plus what has been spent, across the whole job.
Left
What remains of the plan. It reads Over the plan, in red, once the job has cost more than was planned.

Tip — the customer never sees the cost plan. It is your working-out, and they only ever see the quote made from it.
